Trade track · Sports & Commercial Turf

Sports Field Construction in Queensland: Process, Cost Drivers and Timelines

How a natural-turf sports field is built in Queensland, from earthworks and drainage to grow-in, with cost drivers, government benchmarks and timelines from our own field projects.

10 min readLast reviewed By the Hancey's Turf team

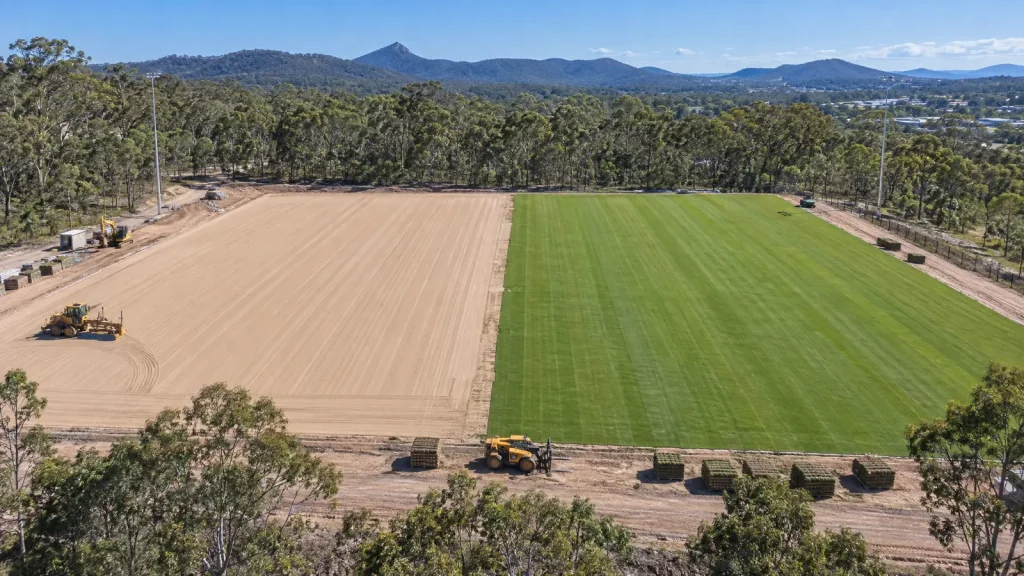

Aerial view of a Queensland sports field being built, half levelled sand rootzone and half new turf, with machinery and pallets

Sports field construction in Queensland follows eight stages: site investigation, design, earthworks, drainage, irrigation, rootzone, turfing and grow-in. On our projects, building has taken four to eight weeks, plus six to 13 weeks of grow-in. The QLD Government’s 2018 benchmark was $434,000 for a natural-grass soccer field, excluding GST. Earthworks, drainage and the rootzone drive the cost.

Key facts

QuestionShort answer
Main stagesInvestigate, design, earthworks, drainage, irrigation, rootzone, turf, grow-in
Build window (our projects)4 to 8 weeks on site, depending on scope and weather
Grow-in before play6 to 13 weeks of mowing, feeding, top-dressing and pest control
Typical surface fallsAbout 1% on a drained field; 1.4% where there is no subsurface drainage
Grading tolerance±10 mm on the subgrade; ±5 mm on a high-spec rootzone

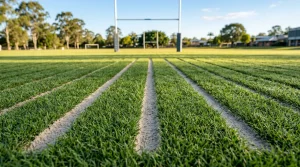

Drain spacing5 to 10 m centres, sometimes with sand or gravel slit bands between
Usual SEQ turfCouch (we grow Wintergreen); kikuyu suits cooler sites such as Toowoomba
Biggest cost swingsEarthworks volume, drainage design, imported sand depth, washed vs unwashed turf
Best time to turf in SEQSpring to early autumn, when couch is actively growing

What sports field construction covers

“Sports field construction” can mean three quite different jobs, and the price and timeline follow from which one you need:

  • New build: a greenfield site in a new school, estate or council precinct, often handed over as a rough subgrade.
  • Rebuild: strip, reshape, drain, irrigate and re-turf an old oval that is compacted, uneven and unplayable after rain.
  • Renovation: keep the existing base and fix the playing surface.

This guide covers natural turf; we compare it with synthetic further down.

The process, step by step

This is the sequence we follow on our sports turf construction projects. The numbers come from our own completed jobs.

StageWhat happensGet it right
1. Site investigationLevel survey, soil tests, service location, existing outlets and irrigationReactive or sodic clay changes the design
2. DesignLayout, falls, drainage, irrigation and rootzone specAbout 1% falls on a drained field
3. EarthworksStrip, decompact, shape with GPS or laser control, add gypsumTrim the subgrade to ±10 mm
4. Drainage100 mm ag pipe in gravel trenches at 5 to 10 m centres to a lawful outletTrench only in dry conditions
5. IrrigationPop-up sprinklers, pump and controller; heads capped and GPS-plottedProtect pipework under the rootzone
6. RootzoneImported sand (100 to 250 mm) or amended native soilPush out from the edge; test compaction and infiltration
7. TurfInspected paddock, slabs or big rolls, washed if specified, laid and rolledHarvest to laid within 18 to 24 hours
8. Grow-inMowing, feeding, top-dressing, rolling, weed and pest controlAgree acceptance criteria up front

Earthworks and subgrade

Mistakes in the subgrade show up for years. At Genesis College in Bray Park, more than 7,000 m³ of soil was moved with machine-controlled dozers, then finished with a laser box blade. At the Les Hughes rugby league fields, also in Bray Park, a machine-control GPS dozer shaped the fields to design. At Samford a laser bucket took the subgrade to ±10 mm at a 1.4% fall, and gypsum was ripped into the clay. More on the soil side on our site and soil preparation page.

Drainage

Drainage keeps a field playable after an SEQ summer storm. The Metricon Stadium training field on the Gold Coast was designed for rainfall of up to 100 mm an hour, with laterals at 5 m centres feeding a ring main. At Bob Brock in Dakabin, pipe at 10 m centres was enough. At Sheldon College, gravel slit bands 500 mm apart connect the surface to the pipes.

Rootzone: sand profile or native soil?

High-spec fields sit on sand: 250 mm with a little peat at Samford and Narangba, 200 mm of amended local sand at Mackay. Sand drains fast and resists compaction but needs more water and fertiliser. At Clive Berghofer Stadium in Toowoomba, the client reused the red clay site soil, decompacted, amended and drained, as a deliberate cost saving.

Turf: paddock selection, slabs or big rolls

For a large job we set aside a paddock early and grow it for the end use. Council specs may require inspection for purity, weeds, density, pests and disease. Slabs harvest thinner than big rolls, which helps rooting, and can be laid at up to 10,000 m² a day against about 4,000 m² for rolls. Washed big rolls suit specs that allow no soil on the sand. Most of our fields use Wintergreen couch grown at Woodford; from a sand-based paddock it can match the profile without washing.

How long does it take?

Plan for two windows, not one: the build window (machines on site) and the grow-in window (turf establishing before play).

  • Build window: 4 weeks at Sheldon College and on the Metricon drainage retrofit, 5 weeks at Clive Berghofer, and about two months at Narangba around wet weather.
  • Grow-in: 6 weeks at Genesis College, 8 weeks at Bob Brock, 10 weeks at Sheldon and Clive Berghofer, 12 weeks at Samford and 13 weeks at Les Hughes.
  • Weather: SEQ summer storms can stop earthworks and trenching for days. Build slack into the program.
  • Season: couch grows strongly from spring to early autumn and slows in winter, so cool-season turfing means a longer grow-in.
  • School holidays: the summer break suits a school oval but overlaps storm season, so have design and turf locked in before the gates close.

If grow-in time is the problem, turf can be pre-grown. For the 2018 Commonwealth Games, in partnership with HG Turf, we grew 25,000 m² of Wintergreen couch in HG’s hybrid turf system at Woodford over a 12-month grow-in, for the opening and closing ceremonies and Metricon Stadium’s main field.

What does a sports field cost in Queensland?

The Queensland Government publishes indicative facility costs for grant applicants. Its current Sport Facilities Costs sheet (prices at May 2026) no longer lists natural-grass football fields. The 2018 facility costs fact sheet did, at June 2018 prices:

Field (2018 fact sheet)AreaNatural grassSynthetic grass
Soccer, 111 × 74 m incl. run-off8,214 m²$434,000$1,555,000
Rugby league or union, 130 × 80 m10,400 m²$550,000$1,968,000
AFL or cricket oval, 175 × 155 m27,125 m²$1,431,000$5,130,000

Use them as a sense check, not a quote:

  • They are June 2018 prices, excluding GST, on a clean, flat SEQ site. Costs have risen since. As an indication only, a natural-grass bowls green went from $169,000 (2018) to $427,800 (2026); the specification may differ between the sheets, so treat this as a signal, not a field escalation rate.
  • Lighting, goals, fencing and accessories are excluded. The 2026 sheet puts new 100 lux LED lighting for a rugby or soccer field at $407,100.
  • Sloping sites and poor soils are excluded, and sites outside SEQ carry a locality index (the 2026 sheet’s index is 117% for Mackay and 102% for Toowoomba and the Sunshine Coast).

The seven cost drivers

  • Earthworks volume: Genesis College moved more than 7,000 m³.
  • Drainage design: pipe spacing (5 m centres need twice the trench length of 10 m), slit bands and the length of run to an outlet.
  • Rootzone: native soil versus thousands of tonnes of imported sand.
  • Irrigation: reusing a working system (as at Bob Brock) or starting new.
  • Turf specification: washed big rolls cost more than unwashed slabs.
  • Access and timing: one gate, events during works or a compressed window.
  • Testing and grow-in: hold points, compaction testing and maintenance length.

Ways to save without cutting corners

Reuse good site soil where tests support it, keep irrigation that still works, source rootzone sand locally (as at Mackay, which also makes matching top-dressing easy), specify unwashed slabs from a sand-based paddock where the profile allows, and book the turf paddock early.

Planning a field build or rebuild? Book a site assessment and we’ll walk the field, check the soil and drainage, and give you a realistic scope before you commit to a budget.

Natural turf vs synthetic for a school or club field: the 20-year cost view

On capital cost, natural turf is well ahead: in the 2018 figures above, synthetic soccer cost about 3.6 times as much. Over 20 years the gap narrows, because the costs fall differently:

  • Natural turf: mowing, fertiliser, water, top-dressing, line marking, periodic renovation, and rest periods when use is heavy.
  • Synthetic: the higher build cost, grooming, infill top-ups, and a carpet replacement within 20 years. Surface heat can also limit use on hot days.

The answer depends on weekly hours of use, so compare whole-of-life costs on the same basis.

Choosing turf for a Queensland sports field

  • Couch is the usual choice on most SEQ fields. It wears hard, recovers fast and handles heat; most of our fields are Wintergreen. Compare the options on our turf varieties page.
  • Kikuyu suits cooler inland sites. Clive Berghofer Stadium in Toowoomba, which swings from about 38°C to below freezing, switched from couch to kikuyu for year-round colour.
  • Hybrid systems suit stadiums and elite venues with very high use.
  • Turf wickets are a specialist job built with cricket clays. The outfield around them is usually couch.

After handover: looking after a new field

The first season decides how the field plays for years. Our grow-in programs have included mowing couch at about 30 mm, rolling, 10 mm sand top-dressings, keeping soil pH around 6 to 7, and core tests for root depth (Samford’s acceptance criterion was 200 mm). Top-dress with the same sand as the rootzone to avoid layering, rotate high-wear areas, and ask for a maintenance manual at handover.

Hancey’s sports field projects

ProjectLocationAreaScopeBuild windowGrow-in
Genesis CollegeBray Park25,000 m²Total rebuild; turfed in 4 days8-week holiday window, incl. grow-in6 weeks
Les Hughes rugby league fieldsBray Park15,000 m²GPS shaping, soil amendment, Wintergreenn/a13 weeks
Bob Brock soccer fieldDakabin7,000 m²Council rebuild, 10 m drains, sand layern/a8 weeks
Samford sports precinctSamford50,000 m² complex250 mm sand, 5 m drains, washed rollsn/a12 weeks
Narangba sports complexNarangba30,000 m²Two soccer fields, 250 mm sandAbout 2 monthsn/a
Sheldon CollegeSheldon9,000 m²Infield, drains and slit bands4 weeks10 weeks
Clive Berghofer StadiumToowoomba9,000 m²Reused clay, 10 m drains, kikuyu5 weeks10 weeks
Harmony sports fieldsPalmview49,000 m² of turfSoil prep, grading, turf supply10 weeks (turfing)n/a
Metricon Stadium training fieldCarrara20,000 m²Drainage retrofit4 weeksn/a
Mackay sports precinct (2018)Mackay7,000 m²Athletics infield, 5 m drainsn/an/a
Commonwealth Games turf (with HG Turf)Woodford25,000 m²Pre-grown hybrid turfn/a12 months (pre-grown)

n/a means the project page doesn’t record that figure. See more on our recent projects page.

How to brief a sports field contractor

A clear brief gets comparable quotes. Include:

  • field size, sports and weekly hours of use
  • the closure window and fixed reopening date
  • funding status and any grant requirements
  • existing survey, soil tests, outlets and irrigation
  • renovation, rebuild or new build (or ask which)
  • turf variety, washing and paddock inspection needs
  • handover criteria: coverage, weeds, root depth, levels
  • grow-in length and who waters during it

Frequently asked questions

How much does it cost to build a sports field in Queensland?

The Queensland Government’s 2018 fact sheet put a natural-grass soccer field at $434,000 and a rugby field at $550,000, excluding GST, lighting, goals and fencing. Costs have risen since, and earthworks, drainage and the rootzone decide the real figure.

How long does a sports turf construction project take?

On our projects, site works have taken four to eight weeks, then six to 13 weeks of grow-in before play. Wet weather and winter turfing both add time.

What does sports field earthworks involve?

Stripping the old surface, decompacting the subgrade, shaping it to the design falls with GPS or laser control and trimming to about ±10 mm, often with gypsum worked into clay.

What is the best grass for sports fields in Queensland?

Couch in South East Queensland, because it wears well, recovers quickly and handles heat. Kikuyu suits cooler inland sites such as Toowoomba.

What grass is used on Australian football fields?

In South East Queensland, most football, rugby and cricket fields are couch. Cooler inland sites often use kikuyu, and some stadiums use hybrid turf. In cooler southern states, ryegrass, or couch oversown with ryegrass, is common on AFL grounds.

Do sports fields need a sand rootzone?

Not always. High-use fields often sit on 100 to 250 mm of sand for drainage and wear. Good native soil can be decompacted, amended and drained instead, at lower cost.

How far apart should field drains be?

On our projects, laterals have run at 5 to 10 m centres depending on falls, soil and rainfall, sometimes with sand or gravel slit bands between them.

Can a school oval be rebuilt in the summer holidays?

Yes, with planning. Genesis College’s 25,000 m² field was rebuilt, turfed in four days and ready for play within an eight-week summer holiday window.

Is natural turf cheaper than synthetic over 20 years?

Natural turf is far cheaper to build; the 2018 government figures put synthetic at about 3.6 times the cost. Over 20 years synthetic adds carpet replacement and infill, and natural adds mowing, water and renovation, so compare whole-of-life costs.

Talk to the grower before you tender

We have grown turf at Woodford since 1994 and supply sports fields and commercial sites across Brisbane, the Sunshine Coast and beyond. If you’re scoping a field build, rebuild or renovation, read about our sports field construction service or book a site assessment to get a realistic scope, budget range and timeline. Prefer to talk it through? Call 1800 761 334 or use our contact page.
